Preconstruction Workflows

Automating Preconstruction Workflows in Commercial Construction

Number of Adaptive Cards for these seven workflows: 55

​Modern commercial preconstruction involves a complex web of processes – estimating, bidding, contract formation, schedule of values, purchase orders, and preliminary scheduling/resource planning – all of which span multiple organizational roles. Effective automation of these workflows requires accommodating different project delivery methods and seamlessly integrating third-party tools via a unified platform. In practice, a single project’s preconstruction phase might involve architects, engineers, city planning authorities, general contractors, specialty subcontractors, and owners, each using distinct systems. This often leads to fragmented information and miscommunication. An AI-driven platform (such as BuilderChain) addresses this by unifying data and communication in one Operational Ontology, ensuring a “single source of truth” across stakeholders. Below, we detail each major preconstruction workflow – including typical steps and exception scenarios – and illustrate how a templated, integrated approach can streamline them.

Supporting Multiple Delivery Methods with Project Templates

Every project may follow a different delivery method, which dictates how the design, bidding, and construction teams collaborate. Common methods include Design-Bid-Build (DBB), Design-Build (DB), Construction Manager at Risk (CMAR), Construction Management Multi-Prime (CMMP), Public-Private Partnership (P3), and Integrated Project Delivery (IPD). A robust preconstruction platform uses project templates tailored to each delivery method so that the workflow fits the project’s contract structure:

Design-Bid-Build (Traditional): Design is completed by architects/engineers first, then a separate bidding phase selects a general contractor. The workflow template would include a formal bid solicitation and evaluation phase after design completion. (Roles: design team, owner for bidding, then GC and subs after award.)

Design-Build: The contractor and designer work as one team from early on. The template reflects continuous contractor involvement during design (early cost estimating, value engineering during design development) instead of a strict post-design bid. (Roles: integrated design-builder team, possibly fewer formal bid steps.)

CMAR / CM Multi-Prime: A construction manager is engaged early to advise on cost and schedule while design progresses. The template includes iterative preconstruction estimates, constructability reviews, and then guaranteed maximum price (GMP) negotiation rather than open bidding.

Integrated Project Delivery: All key participants (owner, designer, contractor, often major subs) enter a single collaborative contract. The template emphasizes early joint planning sessions, shared risk/reward, and continuous estimation – essentially blurring traditional stepwise processes into a collaborative workflow.

Public Bidding (e.g. P3 or government projects): Templates include strict advertisement, open bid submission, and public bid opening steps per regulations, and often prequalification steps.

By supporting these variations, the platform’s templating ensures that, for example, a design-build project can skip redundant steps (no separate bid competition) whereas a public DBB project will include mandated advertisement, sealed bids, and perhaps bid bond verification. This flexibility prevents users from having to “shoehorn” their project into a one-size process. Instead, the template provides a baseline workflow that is then further customizable for the project’s specifics.

The result is a clear, role-specific roadmap for preconstruction that aligns with the chosen delivery strategy, improving efficiency and reducing confusion across teams.

Estimating Workflow in Preconstruction

Accurate cost estimating is the foundation of successful bidding and project planning. Estimating is the process of calculating all costs required for a project – including materials, labor, equipment, subcontractor work, and indirect costs – to ensure the project can be completed within the owner’s budget while allowing a reasonable profit. In a typical commercial vertical construction scenario, a professional estimator (at a general contractor or CM firm) leads this effort, coordinating with design professionals and specialty contractors. Key steps in the estimating workflow include:

1. Review Bid Documents: The estimator thoroughly reviews the bid package (drawings, specifications, contract terms, etc.) to understand the project scope and requirements. All disciplines’ drawings (architectural, structural, MEP, etc.) and the project manual are checked to ensure nothing is missing or unclear. The estimator may highlight items that need clarification (issuing RFIs to the architect if necessary for ambiguities).

2. Scope Breakdown and Work Packages: Especially for a general contractor’s estimate, the project is broken down into work packages or trade categories. For example, site work, concrete, steel, mechanical, electrical, etc. are delineated. This ensures comprehensive coverage of scope without overlaps or gaps. Each work package can later correspond to subcontractor bids. (The estimator must ensure no scope is omitted or double-counted, an important quality check.)

3. Site Visit and Investigations: The estimating team conducts a site visit if possible, to assess local conditions that might affect costs (e.g. access, soil conditions, existing structures, utility locations). They note factors like poor soil or tight site access that could increase costs or require mitigation. The estimator also researches local code requirements, permitting conditions, and labor availability (often involving city planners or permit officials early to anticipate any special requirements).

4. Quantity Takeoff: Using the drawings and possibly BIM models, the estimator performs a quantity take-off for all materials and work items. Modern estimators leverage digital takeoff software or even integrated BIM-to-estimate tools to automate counting and measurement. They quantify everything from cubic yards of concrete and square feet of drywall to the number of light fixtures. This creates a detailed bill of quantities which forms the basis of pricing.

5. Unit Cost Pricing: For each item from the takeoff, the estimator applies unit costs (material costs, labor hours and rates, equipment usage, etc.). They often consult historical cost databases, supplier quotes, and subcontractor quotes. Subcontractor Solicitation: In parallel, the GC sends out RFQs to subcontractors for specialized scopes (e.g. mechanical, electrical). Subs provide pricing for their portions. The estimator integrates these quotes into the estimate, while ensuring they have comparable scope coverage.

6. Cost Build-Up: The estimator aggregates costs for direct work (materials, labor, equipment), subcontractor bids, and adds indirect costs like general conditions (field supervision, site facilities), insurance, and bond fees if required. They also include a contingency allowance for uncertainties and a markup or fee (overhead & profit).

7. Internal Review & Value Engineering: The completed preliminary estimate is reviewed internally. If the estimated cost exceeds the owner’s budget (in a negotiated scenario) or seems non-competitive (in a bid scenario), the team might perform value engineering – identifying changes or alternatives to reduce cost without sacrificing key project goals. This could involve suggesting cheaper material options or construction methods (subject to owner/architect approval).

8. Finalize the Estimate: The final estimate is organized typically by the schedule of values format or CSI divisions, to present a clear breakdown. It may undergo management approval in the contractor’s organization. In a competitive bid, this becomes the basis of the bid price submitted. In a negotiated or CMAR project, it might be presented to the owner as a budget or GMP proposal.

Throughout estimating, collaboration and data exchange are crucial. The architect and engineers may be engaged for clarifications or design adjustments that could save cost (this is common in design-build or CMAR workflows). Specialty contractors might be consulted for input on constructability or lead times for critical materials. An integrated platform can automate many estimating sub-tasks – for example, pulling quantities directly from a BIM model into the cost database, or using AI to flag missing scope by comparing to historical project data. It can also ensure that everyone is referencing the latest design revisions, preventing costly mistakes.

Exceptions & Contingencies: Estimating is often an iterative process with potential exceptions: if bid documents are incomplete or revised late (addenda), the estimator must update quantities and costs rapidly. If a subcontractor’s quote comes in notably high or a quote is missing, the estimator might seek alternate bidders or make a qualified assumption in the estimate. When the owner requests alternate proposals (e.g. for optional add-ons or substitutions), the estimator prepares those in parallel. A good workflow will include steps for risk analysis, such as identifying unusually cost-sensitive aspects of the project (e.g. volatile material prices) and planning contingencies for them. In summary, the estimating workflow produces a detailed, accurate cost model of the project that sets the stage for informed decision-making in bidding.

Bidding and Contractor Selection Workflow

Number of Adaptive Cards for this workflow: 7

Once a reliable estimate is in hand, the focus shifts to the formal bidding process, where contractors compete (or are invited) to execute the project. From the project owner’s perspective, this process determines which contractor (general contractor or construction manager) will be awarded the job; from the contractor’s perspective, this is about compiling the estimate into a compelling bid proposal and winning the contract. The bidding and selection workflow involves multiple parties (owner, designers, bidders, and often external agencies for public work) and typically proceeds as follows:

Bid Solicitation: The owner (or their representative, such as the architect or a construction manager acting as agent) issues a Request for Proposal (RFP) or Invitation to Bid (ITB) to prospective bidders. The solicitation package includes the project plans, specifications, contract terms, bid forms, and the timeline for bid submission. In a public project, this might be an open call advertised to all qualified contractors; in private projects, the owner may use selective bidding, inviting a shortlist of trusted firms. The solicitation phase may include a pre-bid conference or site walkthrough where bidders can ask questions.

Bid Preparation (Contractor’s side): Each invited contractor prepares their bid proposal. This largely means refining the internal estimate to a final bid price, considering any last-minute subcontractor adjustments and adding the desired profit margin. Contractors also compile any required documentation: qualifications statements (especially if an RFQ was part of the process), project approach narratives, preliminary schedules, and other submittals requested (e.g. safety plans). They must ensure bid compliance – filling all forms, securing a bid bond (if required), and not taking exceptions to contract terms unless allowed. During this period, bidders may submit RFI questions to the owner/architect for clarification; answers are typically shared with all bidders to keep a level field.

Bid Submission: By the deadline, contractors submit their bids – often sealed if a formal process, or via an online portal. The bid package usually includes the lump sum price (or GMP or unit prices, depending on contract type) and supporting information. In a design-build or negotiated scenario, the “bid” might be a proposal including design concepts or methods, in which case qualitative factors will also be evaluated.

Bid Evaluation and Leveling: The owner and their team (architect, engineer, or a construction manager advisor) open and evaluate the bids. They typically use a bid tabulation to compare key elements: price breakdowns, durations, qualifications, exclusions, etc. Bid leveling is performed to ensure fairness – adjusting for any scope differences or clarifications needed to make true apples-to-apples comparisons. For instance, if one bidder excluded a certain work item, the owner might add an estimated cost to that bid for evaluation purposes. Besides price, owners consider the contractor’s experience, proposed schedule, means and methods, and compliance with all bid requirements. In some cases, an interview or post-bid meeting is held with top bidders to discuss their proposal in detail (especially for negotiated or high-value projects).

Contractor Selection: Based on the evaluations, the owner selects a preferred bidder. This could be the lowest responsive and responsible bidder (common in public projects where low price dominates), or a best-value selection considering qualifications. The owner may issue a Letter of Intent or conditional award at this stage, signaling the chosen contractor.

Negotiation and Award: After selection, the owner and chosen contractor negotiate final contract terms (if not already fixed). This includes ironing out any remaining scope clarifications, schedule adjustments, and agreeing on unit rates or allowances if applicable. The outcome is the formation of the actual construction contract that both parties will sign. Key contract elements – payment terms, detailed schedule milestones, insurance and bond provisions, etc. – are confirmed and documented. Finally, the owner awards the contract formally (often by issuing an Award Letter or Notice of Award followed by a Notice to Proceed which authorizes work to begin on a certain date).

Example cross-functional flow of a construction bidding process, from initial project specifications through bid preparation, scheduling, and into construction. Each swimlane represents a party or phase (design/specification, bidding, scheduling, construction), illustrating how information flows across roles (owner/design team to bidding contractors to the contractor’s scheduling and field teams). In a collaborative platform, these handoffs are streamlined and visible to all stakeholders.

During the bidding phase, communication and version control are critical. An integrated platform can provide a common data environment where all bidders access the same up-to-date documents, and addenda or Q&A answers are distributed instantly to everyone. This reduces the risk of a bidder missing a last-minute change. It can also enforce compliance by using digital bid forms that validate entries, and even perform automatic bid leveling by aggregating data from each bid submission for the owner’s review.

Exceptions & Special Cases: Several exception scenarios can complicate the bidding workflow. If all bids come in over budget, the owner has a few options: negotiate scope or price reductions with the lowest bidder, inject more funding, or reject all bids and redesign or re-bid the project. A value-engineering round might be conducted, where bidders (especially in a negotiated procurement) suggest cost-saving ideas to bring the project within budget. Alternatively, the project could be split into phases or bid packages to reduce immediate costs. Another exception is if too few bids are received (or none at all); the owner may extend the bid deadline, broaden the pool of bidders, or switch to a negotiated approach with a single contractor. In public work, if the lowest bidder is found non-responsible or fails to furnish required bonds, the owner would award to the next lowest bidder or re-bid if necessary.

Bid withdrawal is another edge case – a contractor may seek to withdraw a bid due to a significant error; the handling of this (allowing withdrawal or holding bid security) will follow the project’s regulations. All these exceptions underscore the need for flexibility: the platform’s workflow should include decision gateways for cases like “Bids over budget?” leading to an alternate branch (such as initiating a redesign or secondary negotiation process). Throughout, maintaining a transparent record of all communications and decisions is important for audit trail and fairness, which a digital platform inherently provides.

Learn More about the 7 Adaptive Cards for this workflow

Contract Assembly and Award

Number of Adaptive Cards for this workflow: 7

Once a bidder is selected, the focus turns to formalizing the construction contract and executing it. The contract assembly workflow ensures that all agreements reached during bidding/negotiation are captured in writing and that both parties fulfill any prerequisites for contract execution. Major steps in this process include:

1. Drafting the Contract: The owner (often through their legal counsel or contract administrator) prepares the Agreement document. Standard industry contract forms might be used (such as AIA or ConsensusDocs templates) or a custom contract. This document includes the contract sum (the winning bid price or negotiated price), the contract time (start, substantial completion date or duration), and references the general conditions and other contract documents (drawings, specs, addenda, etc.). Any negotiated modifications (special conditions, alternates accepted, allowances, unit prices, etc.) are incorporated at this stage so that the contract accurately reflects the final deal.

2. Review and Edits: The draft contract is sent to the selected contractor for review. The contractor’s project manager or contract manager will verify that the scope, price, schedule, and terms match what was agreed. If the contractor had proposed any qualifications in their bid, these must be resolved now. Both sides may discuss and resolve any remaining issues (for instance, clarifying dispute resolution methods, or adjusting insurance requirements). This step might involve a few iterations of edits.

3. Contractor Prerequisites: In parallel, the contractor readies all required pre-award submittals. This typically includes providing performance and payment bonds (for security, if required by the owner), proof of insurance certificates meeting the contract limits, and perhaps documentation like a project-specific safety plan or Minority/Women Business Enterprise (MWBE) participation plan if applicable. The contractor also confirms the key project staff (often the owner requires resumes or approval of the on-site project manager and superintendent as part of the contract).

4. Execution and Award: Once the contract language is agreed upon, the parties proceed to sign the contract. In a formal setting, multiple copies are executed so each party retains originals. The owner issues an official Contract Award notice, accompanied by the executed agreement and other contract documents to the contractor. Typically, shortly after (or concurrently), a Notice to Proceed (NTP) is issued, which establishes the official start date for contract performance and authorizes the contractor to commence work as of that date. This date often triggers the countdown of the construction schedule.

5. Project Kick-off: With the contract in place, the preconstruction phase transitions toward mobilization. A kick-off meeting may be held with the owner, architect, and contractor’s team to align on communication protocols, submittal processes, and to introduce key team members from each side. The contract assembly workflow formally concludes with all legal documents in order, and responsibility for project execution now fully handed to the contractor under those terms.

Throughout contract assembly, the platform ensures that nothing falls through the cracks. For example, all required documents (bonds, insurance, signed agreements) can be uploaded and checked off in a checklist. Stakeholders from legal, finance, and project management can collaborate in reviewing the drafts using a secure workspace. Every change is tracked, creating a clear version history (which is helpful if there are later disputes about contract terms).

Exception scenarios: Occasionally, issues at this stage can delay the award. If the selected contractor fails to produce required bonds or insurance or cannot meet some post-bid requirement, the owner may have to retract the award and move to the next ranked bidder or re-bid the project – an outcome the contract workflow should be ready to handle (perhaps with an “if awardee defaults, then…” branch). In negotiations, if a serious disagreement arises (say, on a contract clause or scope inclusion) that can’t be resolved, the owner might choose not to execute the contract at all and consider other bidders. These cases are rare, but having an audit trail of communications and a defined process for escalating issues (involving legal teams, etc.) is valuable. The platform’s ability to integrate with e-signature tools can also accelerate execution once all is agreed, ensuring no time is lost getting signatures from geographically dispersed executives.

Learn More about the 7 Adaptive Cards for this workflow

Schedule of Values (SOV) Process

Number of Adaptive Cards for this workflow: 6

After contract award, one of the contractor’s first deliverables in preconstruction is typically the Schedule of Values. An SOV is a detailed, line-item breakdown of the contract price, allocating the entire contract sum among various parts of the work. It serves as the basis for progress payments: each month, the contractor will bill for work completed on each line item, and the SOV provides the agreed-upon value of each component of the project. The SOV process ensures transparency in how the contract sum is distributed and helps the owner track progress and budget utilization.

1. Preparation of SOV: The contractor’s project manager or cost engineer will develop the schedule of values spreadsheet. Typically, this list is organized either by trade packages, by CSI Division, or by significant project components. For example, a schedule of values might have lines for “Earthwork,” “Foundations,” “Structural Steel,” “HVAC,” “Electrical,” etc., each with a dollar value that sums up to the total contract price. Indirect costs like general conditions (site management costs), fee, and bond can also appear as separate line items. The contractor might start from their bid cost breakdown, but they may need to adjust granularity to meet the owner’s requirements. (Often owners or architects provide a standard SOV template or format.)

2. Review and Approval: The SOV is submitted to the owner’s representative (usually the architect or engineer administering the contract, or a cost consultant). They review it to ensure the breakdown is balanced and reasonable. For instance, they will check that no line item is front-loaded (overvalued early in the project) or unreasonably low. This is important for cash flow and to protect the owner (the SOV should reflect actual proportional value of work, so the contractor isn’t paid too far ahead of actual progress). If any issues are found, the contractor will revise the SOV. Common adjustments include splitting items that are too broadly lumped or redistributing overhead costs more evenly.

Once approved, the SOV is signed off and becomes the baseline for all future pay applications. Each month, the contractor will apply a percentage complete to each SOV line item to compute the billable amount for that period. The platform can facilitate this by turning the approved SOV into a live payment tracking document.

​​ Role of the Platform: A collaborative platform can standardize the SOV submission and approval. For example, the contractor could fill out an SOV web form (or upload in a structured format), which the architect/owner can then mark up or comment on directly. Because the SOV ties into project financials, integration with the owner’s accounting system or the contractor’s ERP is useful – the approved breakdown can be imported to set up the billing structure. Moreover, any change orders later will require updating the SOV (adding new line items or modifying values), which the system can track formally to maintain the audit trail from original SOV to revised ones.

Exception considerations: If a project has multiple primes or phases, there may be multiple SOVs or a very detailed hierarchical SOV. Also, if the contract is cost-plus or GMP, the schedule of values might initially be more of a budget that gets refined as buy-out occurs. In GMP cases, a Guaranteed Maximum Price breakdown might be submitted for approval similar to an SOV, including contingency buckets, etc. The workflow should handle these variations, perhaps by templating an SOV approval step for any contract type. Another exception: sometimes front-loaded SOVs (contractor intentionally over-allocating value to early activities) slip through – if later discovered, it can cause friction. The platform could help flag anomalies (e.g. if the mobilization or early tasks carry unusually high weight) to assist reviewers.

Learn More about the 6 Adaptive Cards for this workflow

Subcontractor and Purchase Order Issuance

Number of Adaptive Cards for this workflow: 6

With a prime contract in place and an SOV defining the breakdown, the general contractor (or CM) moves to procure all the resources and subcontracted work needed to execute the job. This involves issuing subcontracts and purchase orders (POs) to specialty contractors and suppliers. The workflow for subcontract/PO issuance is critical to lock in prices and commitments with all third parties who will carry out the work. It often runs in parallel with other early preconstruction tasks (like scheduling and permitting).

Trade Buy-Out (Subcontracts): The GC’s project team will award subcontracts to the various trades, often based on the bids received during the estimating phase. In many cases, the subcontractors have already effectively been selected as part of the GC’s bid (the GC carried their quotes). Now the GC formalizes those relationships. The steps include: preparing a subcontract agreement for each trade, which references the master contract terms and includes the specific scope of work, price, schedule milestones, and flow-down provisions from the owner contract. The platform can help by generating these subcontract agreements from templates populated with each vendor’s info and scope. Each subcontractor is sent their contract for signature, and they may need to provide their own insurance certificates or bonds if required.

Material Purchases (Purchase Orders): For equipment and materials that the GC will buy directly (rather than via a subcontractor), the GC issues Purchase Orders to suppliers. A purchase order is essentially a formal order form and a binding agreement to purchase certain goods at an agreed price and terms. For example, the GC might issue POs for items like structural steel (if buying steel to supply to an erection sub), major mechanical equipment, or bulk materials like concrete or lumber. The PO process involves creating a PO document listing the item, quantity, price, delivery date/location, and applicable terms (freight, warranties, etc.), getting it approved internally (often POs over a certain dollar amount require management approval), and then sending it to the vendor. The vendor confirms and the order is logged.

Approval and Tracking: In a manual system, purchase orders can be costly and time-consuming to process, but automation significantly improves efficiency. The platform’s procurement module can ensure that each PO or subcontract goes through proper approval workflows – for instance, the project manager drafts it, a contracts manager or executive approves high-value commitments, and only then is it released to the vendor. This prevents unauthorized commitments and helps maintain budget control. Once approved, POs are logged in the system, encumbering the project budget. The system can integrate with accounting, so that when invoices come in, they match against POs (this is the three-way matching of PO, receipt, and invoice to ensure consistency).

Receiving and Coordination: After POs are issued, the procurement workflow includes receiving the materials or confirming services. For materials, the site team will mark items as delivered (partial deliveries vs. full, noted in the system), and the platform can update the PO status. For subcontracts, “receiving” is more about tracking percent complete of subcontracted work which happens via the schedule and progress reports. The payment of vendors is handled by linking invoices to the POs or subcontracts in the system, ensuring that payments don’t exceed agreed amounts without a change order.

Illustrative purchase order process flowchart. The steps span from creating a purchase requisition, obtaining approvals, issuing the PO to the vendor (supplier or subcontractor), through receiving goods/services and matching invoices, to finally closing the PO. In a construction context, the “Purchasing team” creates POs for materials or equipment, project management (or executives) approve major commitments, and the supplier (or subcontractor) fulfills the order, as shown above. Integrating such a workflow ensures that all procurement steps are authorized and traceable.

​​ Exception scenarios: If a chosen subcontractor backs out or fails to sign the subcontract (perhaps due to error or inability to meet requirements), the GC must quickly select an alternate (often the next-best bid) – the platform should allow substituting one vendor with another in the workflow and flag potential budget impacts if the replacement’s cost differs. If early procurement reveals a long lead item (e.g. a piece of equipment has a very long manufacturing lead time), the GC might issue a PO before the main contract is signed (with owner authorization) – the workflow can accommodate early procurement packages. Should any vendor’s price come in higher than estimated (maybe the GC’s bid carried an allowance that was low), that discrepancy needs management attention and possibly a scope change or budget use.

The procurement workflow thus ties back to the project cost control loop, ensuring any variance between subcontract/PO awards and the original estimate is recorded. In an advanced platform, an AI agent could even predict procurement risks – for example, alert if a critical PO has not been issued by a certain date, or if a subcontractor has not provided insurance yet – and nudge the team to take action. Overall, integrating subcontract and PO issuance into the preconstruction workflow (rather than treating it as a completely separate accounting task) ensures that nothing is forgotten from bid to buy-out. Each item in the estimate can be checked off as either subcontracted or purchased, fulfilling the plan. With all third-party commitments captured in the platform’s ontology, the stage is set for accurate scheduling and cost tracking in the execution phase.

Learn More about the 6 Adaptive Cards for this workflow

Preliminary Scheduling and Resource Planning

Number of Adaptive Cards for this workflow: 8

Concurrent with finalizing contracts and buy-out, the general contractor develops the preliminary construction schedule (often evolving into the baseline schedule). This is a crucial preconstruction activity: it transforms the project scope and estimate into a time-sequenced plan of execution. Alongside scheduling, the contractor plans resource allocation – ensuring the right labor, equipment, and materials are lined up for each phase of work. The workflow for scheduling and resource planning brings together inputs from many parties (the GC’s operations team, subcontractors, perhaps the owner’s timeline requirements, and even city constraints like permit dates or noise ordinances).

Developing the Construction Schedule: The contractor’s scheduler or project manager will list out all tasks needed to complete the project, often starting from a Work Breakdown Structure (WBS) that mirrors the scope breakdown. Tasks are logically linked, identifying dependencies (predecessors and successors). For example, “foundation excavation” must finish before “foundation concrete” can start. Key milestones (permit approvals, inspections, phased turn-overs) are marked. Using scheduling software (Microsoft Project, Primavera P6, or similar), they input durations for each activity based on estimated productivity and crew sizes. The result is a timeline of all tasks, typically visualized as a Gantt chart showing the project from start to finish.

Identifying the Critical Path: Once initial linking and durations are set, the scheduler computes the Critical Path – the sequence of activities that determines the project’s overall finish date. Tasks on this path have zero float, meaning any delay in them will delay the project. Recognizing which tasks are critical (e.g. structural frame erection, or long-lead equipment installation) helps focus risk management. The schedule is adjusted to ensure the critical path is reasonable and to see if any acceleration (fast-tracking or adding resources) is needed to meet the required end date.

Resource Allocation and Optimization: The schedule is not just dates; it’s integrated with resource planning. The team assigns labor crews, key personnel, and equipment to activities. For instance, a concrete pour activity will have a certain number of crews and maybe a crane allocated. By loading resources, the scheduler can see if there are overallocation issues (e.g. the plan unintentionally requires 50 electricians on site which exceeds what’s available locally). They perform resource leveling – adjusting sequences or adding shifts – to resolve conflicts. Materials planning is also embedded: long-lead items are flagged with procurement lead times linked to the schedule (so that the PO issuance activities for those appear in the schedule ensuring, say, the air handling units are ordered 6 months before install).

Input from Subcontractors: Many schedules require input from subs for realism. The GC might conduct preconstruction meetings with major subs (mechanical, electrical, facade, etc.) to validate durations and logic for their portions. Subs might provide their detailed planned sequence which the GC incorporates. This collaborative scheduling ensures buy-in and feasibility.

Schedule Review and Approval: The preliminary schedule is often submitted to the owner and architect for approval (it may even be a contract submittal requirement within, say, 30 days of NTP). The owner’s team ensures it aligns with any contractual milestones (interim completion dates, phased handovers). The city or permitting authorities might need to review certain schedule aspects too – for example, if there are restrictions on when road closures can happen, etc., the schedule must accommodate those. Once reviewed, the schedule becomes the Baseline Schedule for the project.

​​Use of the Platform: With a digital platform, the entire scheduling workflow becomes more transparent. All parties can see a visual schedule (Gantt chart or network) which improves coordination. Importantly, if the platform’s ontology integrates schedule data with other data, then schedule changes can automatically ripple to other parts – for example, if a start date shifts, the system could recalculate forecasted cash flows (via the SOV) or send alerts to procurement if a needed-by date moves up. The platform can also integrate with specialized scheduling tools (many GCs will still use Primavera or similar for complex projects) by importing the schedule or linking via APIs, ensuring one source of truth. Resource libraries (e.g. crew productivities stored in the system’s knowledge base) can assist the planner in estimating durations more accurately.

Exception and Risk Planning: Despite best efforts, schedules often face changes. The preconstruction phase is the time to do risk analysis on the schedule – identifying what could delay key tasks (late permits, unforeseen site conditions, etc.). The team develops contingency plans and maybe includes buffer activities or adds float where possible for high-risk items. For example, if a critical piece of equipment could be late, they might schedule a backup activity for a temporary solution or at least note a decision deadline. In some contracts (especially IPD or CMAR), the schedule may be built with input from an independent scheduler or even require a schedule risk analysis (Monte Carlo simulation) to quantify confidence in meeting dates.

Learn More about the 8 Adaptive Cards for this workflow

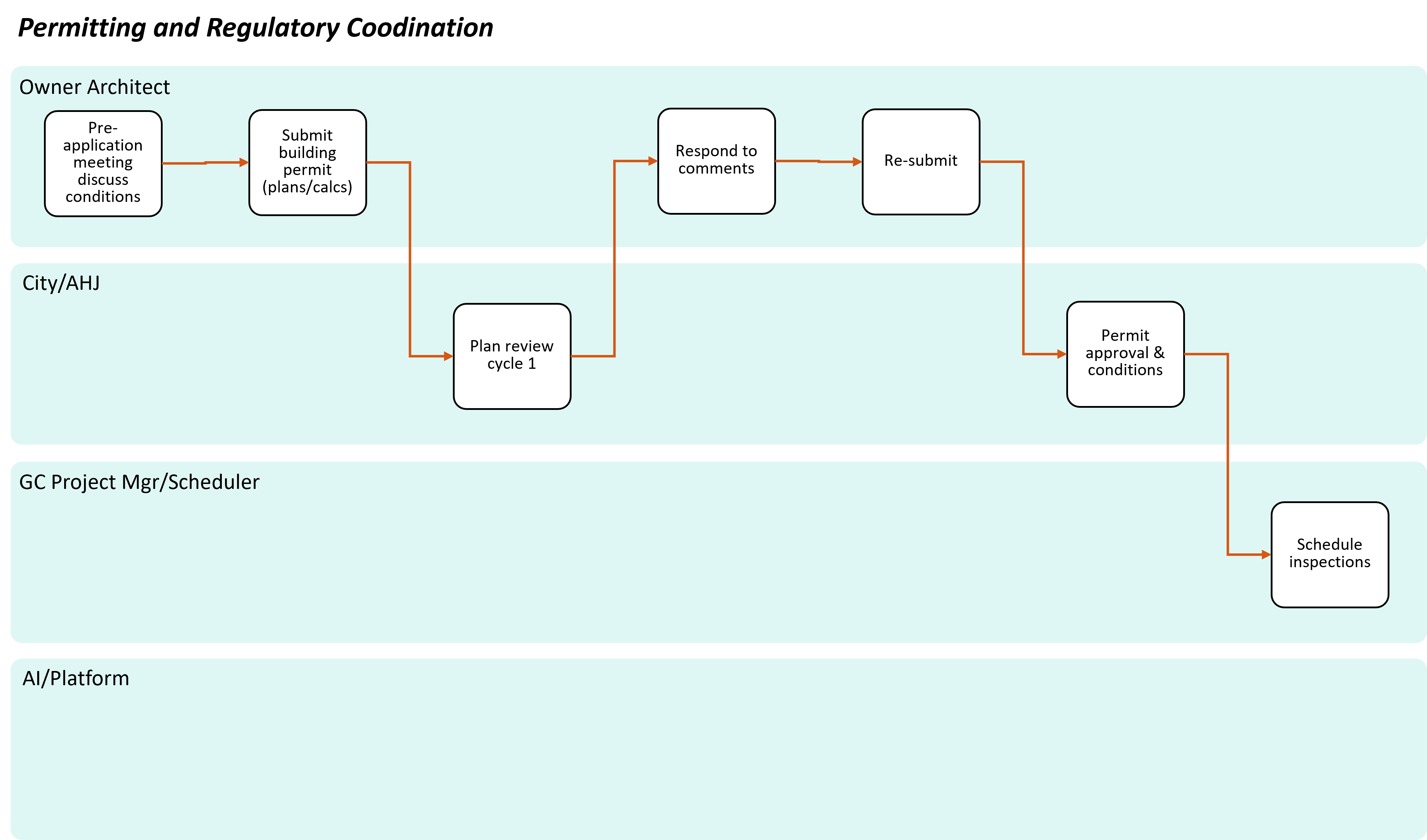

Permitting and Regulatory Coordination

Number of Adaptive Cards for this workflow: 6

Another vital thread in preconstruction – often involving city planners and authorities – is obtaining all necessary permits and approvals. In U.S. commercial construction, the project cannot proceed without permits (building permit, zoning approvals, environmental clearances, etc.). The permitting process usually begins in parallel with design and continues through preconstruction, requiring coordination between the project team and government agencies. Key activities in this workflow include:

1. Pre-Application and Planning Approvals: Early on, the owner/architect engages city planning and zoning officials to ensure the project complies with land use, zoning ordinances, and community plans. For large projects, public hearings or planning commission approvals may be needed (e.g. for zoning variances or site plan approval). The preconstruction team tracks these meetings and outcomes, as they can impact project scope or schedule (for instance, a condition of approval might limit working hours or require a redesign of certain aspects).

2. Building Permit Application: The architect (as the designer of record) compiles the building permit application, including sealed plans, engineering calculations, energy compliance documents, etc. During preconstruction, the contractor may assist by providing construction means and methods details if required (e.g. a demolition plan or traffic control plan for crane operations). The application is submitted to the city’s building department.

3. Plan Review and Comments: City plan examiners review the submission, often sending back a comment letter with required corrections or clarifications. The design team (and sometimes the contractor) address these comments – which might involve changes to drawings or adding information. This cycle can repeat for multiple rounds until all code issues are resolved.

4. Permit Issuance: Once requirements are met, the city issues the building permit (and other associated permits like electrical, plumbing, mechanical permits). This usually comes with a list of required inspections and any special conditions. Preconstruction isn’t over until the permit is in hand – so the team monitors this closely. The start of construction is scheduled based on when permits are expected.

5. Other Permits: Aside from the main building permit, there are often many secondary permits: excavation permit, utility connection permits, environmental permits (stormwater pollution prevention plans, etc.), fire department permits for fire safety systems, and right-of-way permits for sidewalk or street closures. The workflow must encompass all of these. Each has its own lead time and possibly separate agency approval. For example, a city planner might be involved in approving a landscaping plan or signage, while the fire marshal needs to okay the fire alarm and sprinkler plans.

6. Coordination with Schedule: The permitting milestones are linked to the schedule (as discussed). If any permit is delayed, it could delay the corresponding work start. Thus, the team might do some out-of-sequence planning: e.g., “If foundation permit is late, can we do any site clearing under a separate early permit?”. The platform can track permit statuses and alert if any are in danger of delaying critical activities.

In the platform, a permit tracking workflow ensures all approvals are identified and assigned to responsible parties. Documents submitted to agencies can be stored for reference. Some advanced integrations may even allow direct communication with e-permitting systems (many cities now have online permit portals). At minimum, the platform serves as a central log so that, for instance, the general contractor can see that “Planning approval obtained on X date; Building permit expected by Y date” and can plan accordingly.

Exception handling: Permitting is an area with frequent unforeseen delays. An exception scenario is if the plan review uncovers a major code issue requiring redesign – this could send the project back to the design phase for a bit. The workflow should accommodate a feedback loop: design changes due to permit comments should trigger an estimate update and schedule check (since a change could affect cost and time). Another scenario: community or political issues might put a hold on permits (e.g. a neighboring property owner files an objection). This could introduce significant delays or additional requirements (like added soundproofing). The project team must adapt quickly – possibly securing temporary permits to do some work or resequencing to focus on areas not impacted by the hold. Through all this, maintaining a good relationship with city planners and inspectors is key. Early and proactive communication (such as the pre-application meetings) can resolve many issues before they affect the project.

By integrating permitting into the overall preconstruction plan, the platform ensures that regulatory steps are not treated as an external black box. Instead, they are visible tasks with owners and due dates, which can be chased and managed like any other deliverable. When done right, this results in fewer last-minute surprises and a smoother transition into actual construction, with all necessary approvals in place.

Learn More about the 6 Adaptive Cards for this workflow

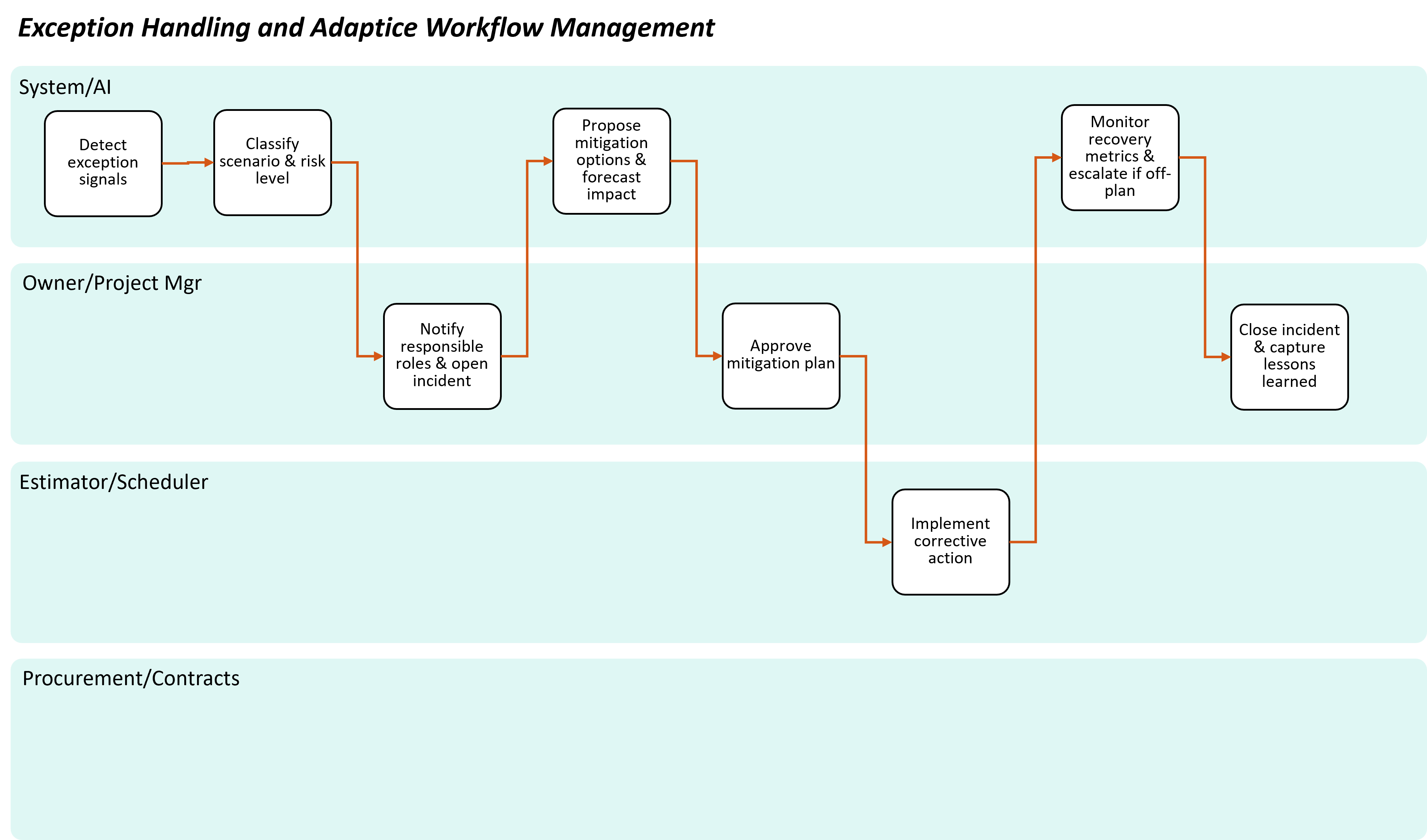

Exception Handling and Adaptive Workflow Management

Number of Adaptive Cards for this workflow: 15

Throughout the descriptions above, we noted various exception conditions – essentially, the “what ifs” that can derail a linear process. A hallmark of a robust preconstruction workflow (especially one managed by AI-driven automation) is the ability to detect exceptions early and adjust the process dynamically. Let’s summarize key exception scenarios and how the platform would handle them:

1. Estimate Over Budget: If the initial estimate shows costs exceeding the owner’s budget (common in early design stages), the workflow branches into a Value Engineering loop. The platform can facilitate collaboration between estimator, architects, and key subs to identify cost-saving options (e.g. alternate materials or design simplifications). After implementing changes, the estimate is revised. This loop may repeat until alignment is achieved. The system logs each iteration and decision for transparency.

2. Bid Outcomes Variance: If bidding results in all bids above the budget or no satisfactory bid, the platform would trigger a decision point for the owner: either negotiate with the lowest bidder, re-bid (perhaps with a wider pool or adjusted scope), or consider switching delivery method (e.g., move to a design-build approach if competitive bid failed). With AI assistance, the system might even analyze bid data to suggest why costs were high (e.g. “all bidders priced X work very high, indicating a market shortage; consider deferring that part of the project”). This helps the team make an informed strategy adjustment.

3. Contract Execution Issues: If the selected contractor fails to sign or provide required security, the workflow immediately flags this high-risk issue. The platform could have a pre-set rule: after a certain grace period, auto-notify the second-place bidder or alert management to prepare alternatives. All communications (like any warnings given to the first contractor) are documented to protect the owner’s legal position before moving on.

4. Permit Delays: The system tracks permit submission and expected approval dates. If a date slips, it will notify the scheduler to update the plan. In an automated scenario, the AI agent might run a quick analysis to find which activities are impacted by the delay and suggest resequencing (e.g., “Excavation permit delayed 2 weeks: consider starting drainage work on another part of site first, which doesn’t need that permit”). This kind of proactive adjustment reduces idle time.

5. Scope Change or Redesign: It’s not uncommon that during preconstruction an owner decides on a scope change (e.g. adding a basement level, or changing a major equipment type) due to new information or opportunities. The workflow can incorporate a change management sub-process: the design team issues revised drawings, the estimator updates costs, the scheduler updates timeline, and if necessary, the contract (or bid) is amended via addendum or change order. The integrated environment ensures each stakeholder sees the change and its effects on their domain (design change triggers notification to estimator, etc.).

6. Resource Shortages: Suppose the resource plan reveals a shortage – e.g., the project needs 100 ironworkers during peak steel erection, but the local labor market can only supply 70. The platform, through its knowledge base or integration with industry labor data, might forecast such a shortfall. Exception handling here could involve adjusting the schedule to stagger work (reducing simultaneous demand), or initiating early outreach to source additional crews (perhaps from other regions). The AI might even simulate the cost impact of overtime vs. hiring more crews to advise the best course.

7. Risk Events: Preconstruction planning tries to anticipate risks (soil issues, price spikes, etc.), but if a risk actually materializes (for instance, a spike in material cost for steel or fuel between estimate and procurement), the platform needs to alert the team to revisit budgets. It could suggest using contingency funds or finding alternate suppliers. Because the Operational Ontology ties together schedule, cost, and scope data, a smart platform can quickly show where the impact will hit: e.g., “Lumber prices up 15% – this will increase Framing cost line by approximately $X, and overall project estimate by Y%.” The team can then decide to absorb the cost, negotiate with the owner, or alter the plan (maybe use an alternative material).

8. Communication Breakdowns: A common source of error is miscommunication – e.g., a subcontractor not getting the latest drawing revision, or the owner not being informed of a change. The integrated platform largely prevents this by maintaining a single truth, but if someone operates outside the system (emailing an old plan, etc.), the AI can detect discrepancies (like an inconsistency between a subcontract scope and the latest plans) and flag it. BuilderChain’s system, for example, is designed to eliminate those data silos and fragmentation issues that cause rework and delays. When humans do go off-script, exception handling means re-aligning everyone to the platform and logging any decisions made off-system into the system retrospectively for completeness.

In essence, adaptive workflows in preconstruction mean that the plan is not static. The system continuously monitors for triggers that indicate a deviation from plan or a risk to the project’s objectives. When found, it either automatically adjusts minor parameters or escalates to the project team with actionable intelligence. This approach significantly reduces the costly surprises during construction (which traditionally result in 52% of rework coming from miscommunication and bad data). By catching exceptions in preconstruction, the team can solve problems while they are still on paper (or in silicon, in this case) rather than on the jobsite where it’s far more expensive and time-consuming to fix.

Learn More about the 15 Adaptive Cards for this workflow

Integration via BuilderChain’s Operational Ontology and Third-Party Tools

All of these complex workflows involve numerous specialized software and data sources – BIM models from design software, schedules in scheduling tools, estimating spreadsheets or databases, procurement systems, etc. BuilderChain’s platform exemplifies how a modern solution can integrate these third-party systems into a cohesive whole. At the heart is an Operational Ontology – a structured, machine-readable representation of all project knowledge (activities, resources, costs, requirements). This ontology acts as the common language that different tools plug into, enabling seamless data flow and context sharing across applications.

In practice, integration works as follows: The BIM model (from, say, Revit) can be linked, allowing quantities and elements to flow into the estimating module. The scheduling tool (Primavera or Project) feeds task data and dates into the ontology, linking with the cost data (so each schedule activity knows which cost items or SOV lines it impacts). Financial systems (ERP or accounting software) connect so that budgets, commitments (POs), and actual expenditures are aligned in real-time with the estimate and SOV – no more spreadsheets floating around out of sync. Even external databases (like a weather service or market price index) could tie in, enriching the ontology with risk-related data (e.g., rain forecasts or steel price trends). BuilderChain emphasizes that everything from Building IoT sensor data to unstructured field reports becomes part of this integrated knowledge base.

What does this enable?
Automation and AI assistance. Because all data is connected, the platform’s AI agents (such as ConstructOps and MetroFlow Optimizer) can reason over the entire project context. For example, an AI agent can automatically check a submitted schedule against the project’s contractual milestones and resource pool – flagging if any violations or unrealistic allocations are found (something that would require tedious manual cross-checking otherwise). It can also look at the estimate vs. actual buy-out costs and predict projected final costs, alerting the team early if a budget overrun is likely unless actions are taken (this is essentially implementing an Earned Value Management mindset from day one). Another agent might monitor communications: if an architect’s design change (uploaded as a new drawing) doesn’t have a corresponding estimate change entry, it will prompt the estimator to review – preventing scope creep from going unnoticed.

Crucially, third-party integration means teams don’t have to abandon their favorite tools. Instead, BuilderChain (or similar platforms) acts as an orchestration layer. A general contractor can continue doing detailed estimates in their estimating software, but the platform will import the key results and link them to everything else. An owner can see that, say, a change in design (logged through a Procore RFI, perhaps) led to a cost impact (from an updated estimate line item) and a schedule impact (an added activity), all in one dashboard. This traceability is often missing when systems are siloed.

Security and permissions are also handled in the ontology – for instance, a subcontractor might interface with the system via a third-party bid submission portal, which writes their bid values into the ontology, but they only see data relevant to their scope. Meanwhile, the owner’s view aggregates high-level info without exposing every granular detail or internal markup unless desired. The ontology can enforce these role-based views while keeping the underlying data consistent.

Finally, integrating external stakeholders: City permit systems or planning commission schedules might not be directly integrated (though in some smart cities, APIs exist for permit status). At a minimum, the platform can ingest data via CSV or manual updates to maintain a single status dashboard. Imagine a project manager’s cockpit where they see:

Design Status:
100% CDs approved; Estimate: GMP of $X (approved); Bidding: completed, Contractor selected; Permits: building permit pending, expected 2 weeks (system highlights risk if it goes beyond 3 weeks based on schedule); Schedule: baseline set, critical path clear; Procurement: 60% of subs awarded, 3 POs pending approval. All this is possible only with integration.

Conclusion

In summary, the operational ontology and integrations turn the preconstruction phase into a well-coordinated symphony instead of a disjointed set of solos. When all tools and participants speak the same language, miscommunications drop, and productivity rises, addressing the longstanding industry paradox of low productivity despite high stakes. The BuilderChain platform, for example, demonstrates quantifiable ROI by reducing rework, delays, and admin overhead through this connected approach. In practical terms, that means projects that start construction with a rock-solid foundation: the right scope, cost, schedule, and risk plan, all understood and agreed by everyone. Automation doesn’t remove humans from the loop – rather, it empowers the project teams (owners, architects, engineers, contractors, and regulators alike) to collaborate more effectively, focusing their expertise on decisions and creativity, while routine coordination and data handling are taken care of in the background.
